Georgia Tech’s research enterprise continues to grow in scale, complexity, and impact. To ensure our Office of Sponsored Programs (OSP) is best positioned to serve the Institute effectively, Georgia Tech engaged Huron, a nationally recognized consulting firm specializing in research administration. This collaboration evaluated OSP’s structure, workflows, performance, systems, and service model to enhance effectiveness and support the research community.
Project Updates

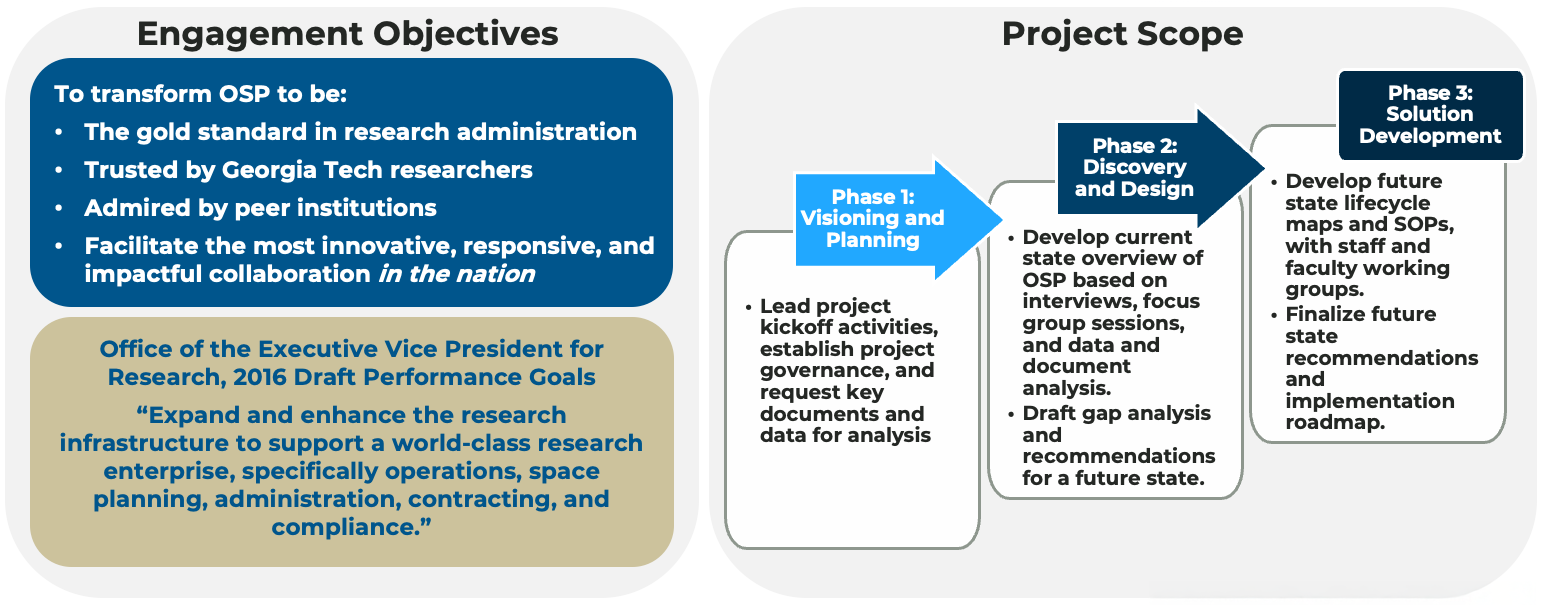

October 1, 2026 — Project Compass is currently in Phase 4: Implementation
- Lead project kickoff activities, establish project governance, and request key documents and data for analysis.
- Develop current state overview of OSP based on interviews, focus group sessions, and data and document analysis.
- Draft gap analysis and recommendations for a future state.
- Develop future state lifecycle maps and SOPs, with staff and faculty working groups.
- Finalize future state recommendations and implementation roadmap.
- Implement prioritized quick wins
- Optimize organizational advancements
As part of the Discovery phase of the project, more than 50+ interviews and focus groups with ~200 attendees across eight units.”
The following highlights upcoming communication and outreach activities:
- What's the Buzz in Research Administration Meeting - October 29, 2026
- Research Administration Mini-What's the Buzz – Date TBD (1st week of December)
OSP Quick Wins
OSP Quick Wins includes more than 100 focused process and organizational improvement projects addressing priority opportunities identified through COMPASS. These projects support practical improvements to processes, policies, technology and data, sub-award administration, and customer service, with implementation continuing through March 2027.
- Process and Policy
- Technology and Data
- Sub-award
- Customer Service
- Change Management
Key Points of Contact:
- Project Sponsor: Brandon Strickland (brandon.strickland@gatech.edu)
- Project Leaders: Deja Tomlinson (djackson86@gatech.edu) and Linda Mazzeo (linda.mazzeo@gatech.edu)

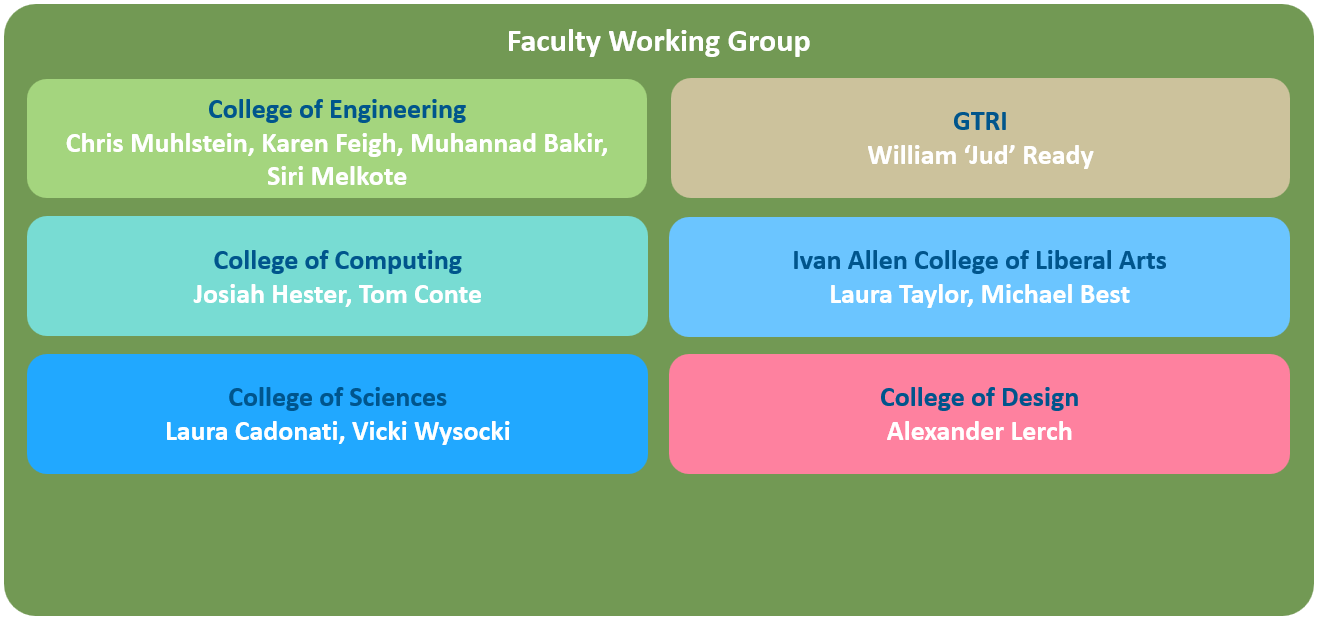

Steering Committee
View PDF for additional details about the Steering Committee.

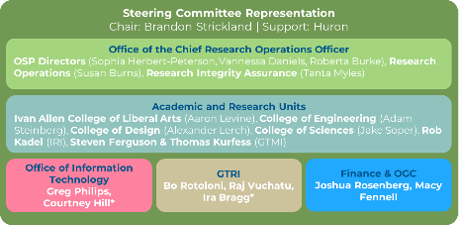

Steering Committee Representation
Chair: Brandon Strickland | Support: Huron
Office of the Chief Research Operations Officer
OSP Directors (Sophia Herbert-Peterson, Vannessa Daniels, Roberta Burke), Research Operations (Susan Burns), Research Integrity Assurance (Tanta Myles)
Academic and Research Units
Ivan Allen College of Liberal Arts (Aaron Levine), College of Engineering (Adam Steinberg), College of Design (Alexander Lerch), College of Sciences (Jake Soper), Rob Kadel (IRI), Steven Ferguson & Thomas Kurfess (GTMI)
Office of Information Technology
Greg Philips, Courtney Hill*
GTRI
Bo Rotoloni, Raj Vuchatu, Ira Bragg*
Finance & OGC
Joshua Rosenberg, Macy Fennell
